Is Your Concrete Restoration Timeline Realistic?

Concrete Restoration Timeline

The Timeline Detail Most Communities Miss

When planning a concrete restoration project, many communities focus on the construction phase.

But the truth is, the timeline starts much earlier.

From the initial assessment to contractor selection, permitting, and mobilization, a typical concrete restoration project can require 6-8 months before construction even begins, assuming everything moves on schedule.

That means a signed agreement today may not lead to active construction for several months.

For boards and property managers, early planning is not just helpful. It is essential.

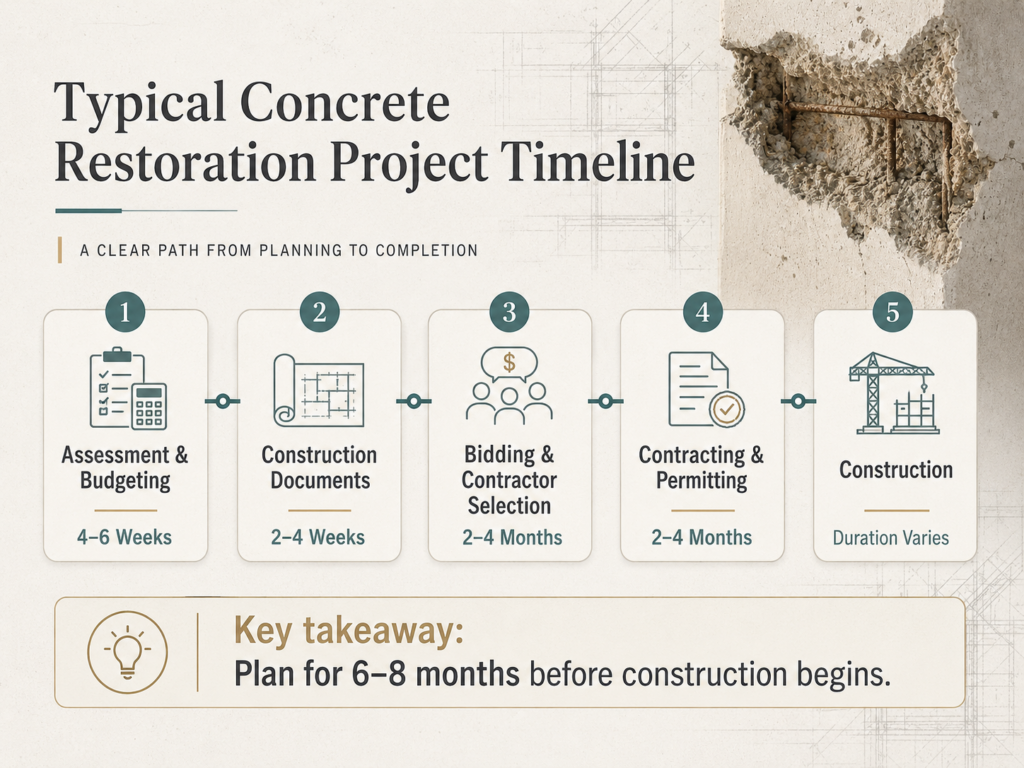

Typical Concrete Restoration Project Timeline

Part 1: Assessment & Budgeting

Estimated Timeline: 4-6 Weeks

This is where the project starts to take shape.

During this phase, the building’s condition is reviewed, repair needs are identified, and the board begins to understand the estimated scope and budget.

This may include:

  • Structural condition assessment
  • Repair scope development
  • Budget estimate preparation
  • Board review and approval

Part 2: Construction Documents

Estimated Timeline: 2-4 Weeks

Once the scope is approved, the next step is preparing the repair plans and specifications that contractors will use to bid on the project.

This phase may include:

  • Preparation of repair plans and specifications
  • Board review
  • Final approval

Part 3: Bidding & Contractor Selection

Estimated Timeline: 2-4 Months

This is one of the most important phases in the process, and often one of the most time-consuming.

Boards must allow enough time for contractors to review the scope, ask questions, submit bids, and participate in interviews before a final selection is made.

This phase may include:

  • Pre-bid meeting
  • Contractor bidding period
  • Bid review and comparison
  • Contractor interviews
  • Board selection of a contractor

Part 4: Contracting & Permitting

Estimated Timeline: 2-4 Months

After a contractor is selected, the project still needs to move through contract negotiations, permit preparation, municipal review, and approval before work can begin.

This phase may include:

  • Contract negotiations
  • Permit preparation and submission
  • Municipal review
  • Permit approval
  • Contractor mobilization

Part 5: Construction

Timeline Varies Based on Project Size and Scope

Once construction begins, the duration depends on the size of the building, the extent of repairs, access requirements, weather conditions, contractor availability, and overall project complexity.

Key Takeaway

A concrete restoration project is not only about the time spent on-site.

From initial assessment to permit approval, communities should typically plan for 6-8 months before construction begins.

Early forecasting can help boards avoid emergency repairs, contractor shortages, budget surprises, and unnecessary schedule delays.

If your community has a concrete restoration project coming up, now is the time to start asking: Is our timeline realistic?
